UAE E-Invoicing Deadlines & Penalties: The Complete 2026–2027 Guide

Every deadline in one table, the AED 50 million test that decides your phase, the five violations under Cabinet Decision 106 of 2025, and a backward plan from your go-live date.
July 16, 2026 by
UAE E-Invoicing Deadlines & Penalties: The Complete 2026–2027 Guide
Foxedg Ventures FZE LLC


IF YOUR REVENUE IS

AED 50M or above

PHASE 1 · ALSO CALLED WAVE 1


Appoint an ASP by

30 Oct 2026

Go live

1 Jan 2027

IF YOUR REVENUE IS

Under AED 50M

PHASE 2 · MOST SMES


Appoint an ASP by

31 Mar 2027

Go live

1 Jul 2027


THE SHORT ANSWER

UAE businesses with revenue of AED 50 million or more must appoint a Ministry of Finance Accredited Service Provider (ASP) by 30 October 2026 and issue e-invoices from 1 January 2027. Businesses below AED 50 million appoint by 31 March 2027 and go live 1 July 2027.

Failing to appoint carries AED 5,000 per month, per entity, under Cabinet Decision No. 106 of 2025 — one of five violations.


Key facts at a glance — UAE e-invoicing
Phase 1 — revenue at or above AED 50M · appoint / live ·
Phase 2 — revenue under AED 50M · appoint / live ·
Government entities · go live
Failure to appoint an accredited service provider AED 5,000 / month
Voluntary pilot · open since
Pilot participants Penalty-exempt

Every month past its UAE e-invoicing deadline now costs a business AED 5,000 — per entity, recurring until it complies. For a five-entity group, a six-month delay is an AED 150,000 line item that buys nothing.

The countdown is no longer theoretical. The voluntary pilot went live on 1 July 2026, and the first mandatory milestone — the Phase 1 deadline to appoint an accredited service provider — falls on 30 October 2026, and the go-live date behind it, 1 January 2027, sits inside year-end close. Yet most guidance available to CFOs and finance directors is written by the very providers competing to be appointed, which makes it selling material, not planning material.

This guide is the neutral version. It covers every deadline in one table, the AED 50 million test that decides which Phase you are in, the full penalty math under Cabinet Decision 106 of 2025, and the integration sequence between signing an ASP contract and actually going live.

What is the UAE e-invoicing mandate?

The UAE e-invoicing mandate requires businesses to exchange structured electronic invoices in the PINT AE format through Ministry of Finance Accredited Service Providers over the Peppol network, with invoice data reported to the Federal Tax Authority.

It replaces PDF and paper invoicing for business-to-business and business-to-government transactions, phased in from 2026 to 2027.

The change is more fundamental than it first appears. A PDF attached to an email is a picture of an invoice; a PINT AE e-invoice is machine-readable data that travels system-to-system, is validated before delivery, and is reported to the tax authority as it moves. Invoices that fail validation do not reach the customer.

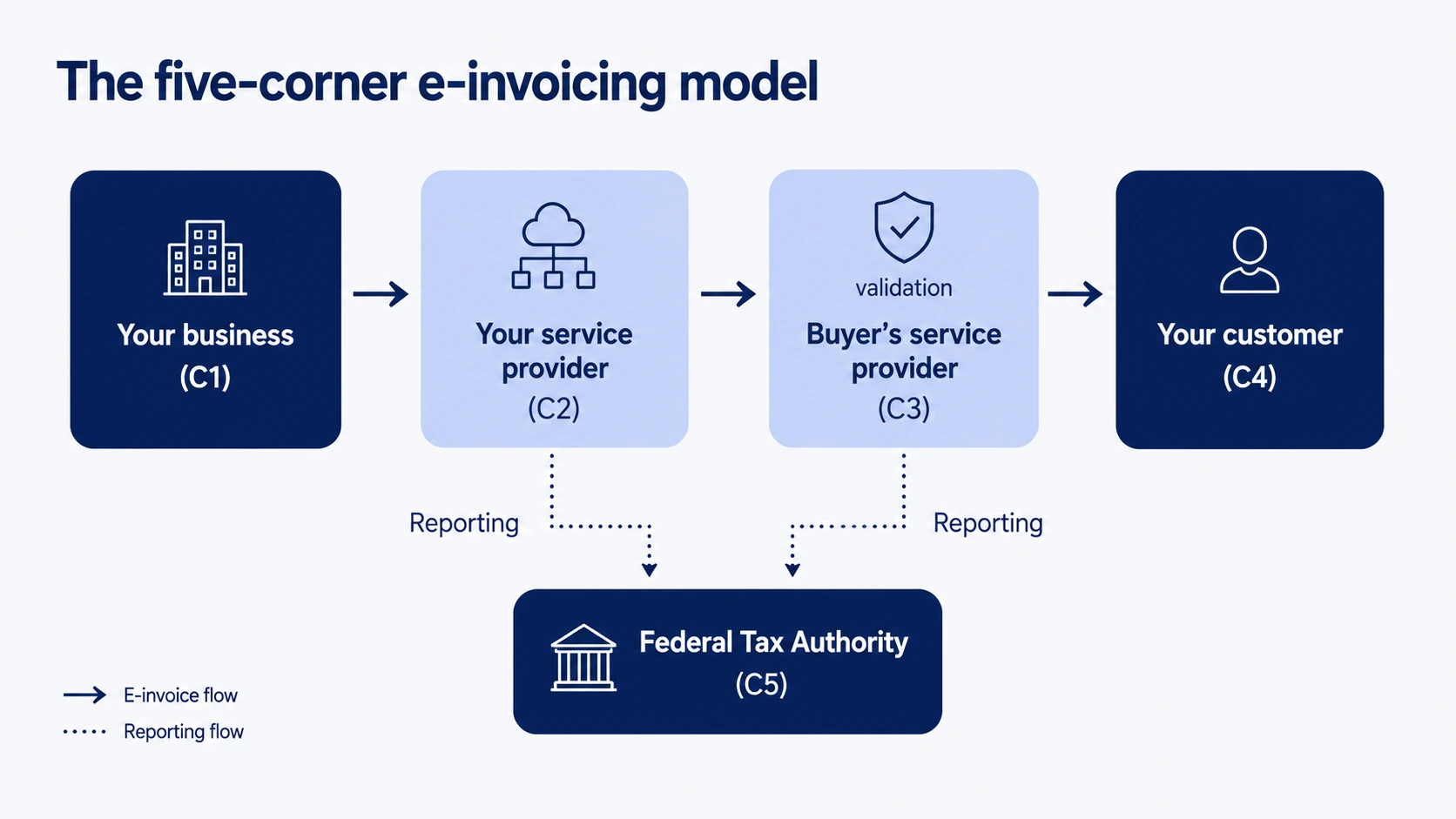

The UAE five-corner e-invoicing model (DCTCE) Invoice data flows from the supplier's system through both parties' Ministry of Finance Accredited Service Providers to the buyer's system, while the Tax Data Document is reported in parallel to the Federal Tax Authority. The five-corner model (DCTCE) CORNER 1 · SUPPLIER Your ERP or billing system CORNER 2 · YOUR ASP Validates, converts to XML CORNER 3 · THEIR ASP Validates or rejects CORNER 4 · BUYER Receives into their system CORNER 5 · FEDERAL TAX AUTHORITY Receives the Tax Data Document E-invoice flow Reporting flow

If validation fails at corner three, the invoice halts there: no tax data is reported, and the rejection is confirmed electronically to your ASP and the FTA. Government entities themselves join from 1 October 2027.

The legal framework sits with the Ministry of Finance and the Federal Tax Authority, with penalties set out in Cabinet Decision No. 106 of 2025. The Ministry of Finance maintains the register of accredited providers under Article 16 of Ministerial Decision No. 64 of 2025 — covered in full below.


WORTH REMEMBERING

A PDF is a picture of an invoice. A PINT AE e-invoice is data that is validated before it is delivered — and an invoice that fails validation never reaches your customer.


Every UAE e-invoicing deadline for 2026 and 2027

There are three UAE e-invoicing deadlines. Businesses with revenue of AED 50 million or more must appoint an ASP by 30 October 2026 and go live on 1 January 2027. Businesses under AED 50 million must appoint by 31 March 2027 and go live 1 July 2027. Government entities follow from 1 October 2027.

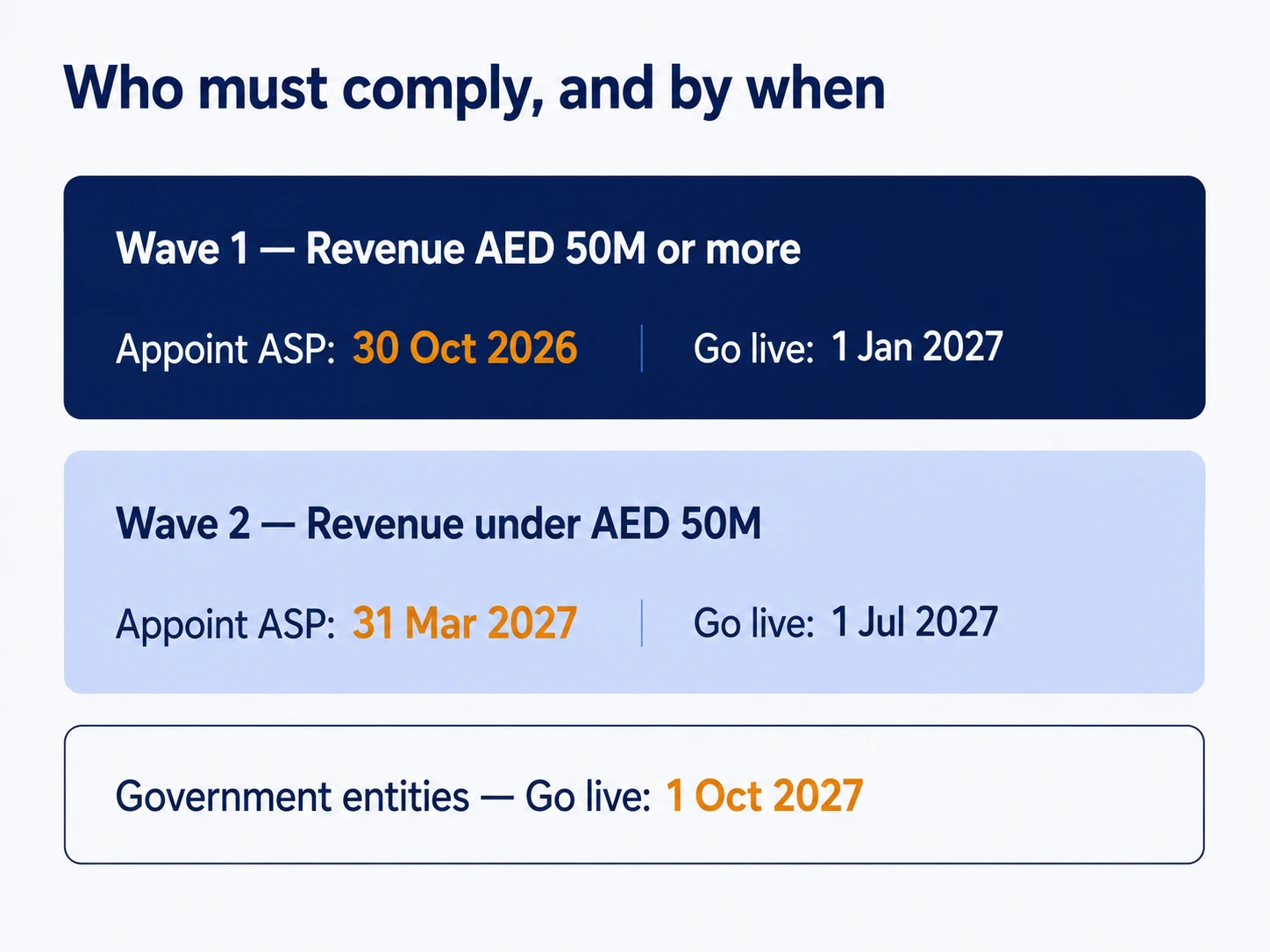

UAE e-invoicing deadlines by revenue
Ministerial Decisions 243 and 244 of 2025, issued 28 September 2025
Appointment and go-live dates for each UAE e-invoicing phase, by annual revenue.
Phase Who it covers Appoint an ASP by Go-live
Pilot Voluntary, any size open now
Phase 1also called Wave 1 Revenue at or above AED 50 million
Phase 2most SMEs Revenue under AED 50 million
B2G Government entities
Last verified 22 August 2026 · foxedg.com · Foxedg is not a Ministry of Finance Accredited Service Provider

Each phase carries two distinct obligations. Appointing an ASP is a formal engagement — selecting and contracting an accredited provider by the deadline. Going live means your ERP is actually issuing compliant PINT AE invoices through that provider. The first is paperwork; the second is a systems project, and it is where the time goes.


The 31 July 2026 date you may have seen is superseded

The Phase 1 appointment deadline was originally 31 July 2026. The Ministry of Finance extended it to 30 October 2026 in response to market readiness.

It would be a mistake to read that extension as a pattern: the go-live dates did not move, and no further extensions have been announced. The superseded date is still widely published, including by established partners and audit firms.

For Phase 1, the calendar is unforgiving in another way. A 1 January 2027 go-live puts final testing and cutover in December — squarely inside year-end close, audit preparation and, for many IT teams, a change-freeze window. Businesses that leave integration to Q4 will be doing their most delicate systems work at the worst possible time of year.

Which deadline applies to your business?

Your deadline depends on annual revenue. At or above AED 50 million you are in Phase 1. Below AED 50 million you are in Phase 2. The test applies to each juridical entity individually, not to the consolidated group.

For a single-entity business with revenue clearly on one side of the line, the test is simple. The complications arrive with structure — and in manufacturing, wholesale and construction, structure is the norm rather than the exception.

How "revenue" is defined

Revenue for the AED 50 million test means the gross income earned by a Person during its most recent accounting period, based on financial statements prepared under UAE legislation. Newly established companies use projected revenue for the ongoing financial year.

Groups and tax groups

Groups with entities of mixed sizes should not assume a single date. The legislation treats each member of a Tax Group as an individual Person for e-invoicing purposes: each member is assessed against the threshold separately and must onboard individually using its own 10-digit Tax Identification Number (TIN), not the Tax Group representative's TRN. Even intra-group transactions between members of the same VAT group are within scope.

Free zone entities

Free zone entities are fully in scope, on the same AED 50 million threshold. E-invoicing applies to any Person conducting business in the UAE, regardless of VAT registration status or whether the entity is established on the mainland or in a free zone.

One scenario needs attention: where the customer is a free zone entity but the ultimate beneficiary of the supply is a different party, the e-invoice must capture the beneficiary's details.

Hovering near AED 50 million?

This is a practical question rather than a legal one. If revenue could cross the threshold, plan on Phase 1 timelines. The cost of preparing early is a few months of lead time; the cost of discovering in November that you were Phase 1 all along is a compressed integration project executed at rush prices.

Multi-entity groups have a planning advantage if they use it: sequence the rollout. Take the largest or most complex entity through first, absorb the lessons, and templatise the work for the rest.

What are the penalties for non-compliance?

Cabinet Decision No. 106 of 2025 defines five separate violations, not one. Failure to appoint an accredited service provider carries AED 5,000 per month, recurring until the business complies, and applying per non-compliant entity.

VIOLATION

PENALTY

Failure to appoint an accredited service provider

AED 5,000

per month

Invoice not issued on time

AED 100

per invoice capped at AED 5,000 per month

Credit note not issued on time

AED 100

per credit note · capped at AED 5,000 per month

Failure to notify the FTA of system failures

AED 1,000

per day

Failure to notify the ASP of registered data changes

AED 1,000

per day

Two of the five are notification failures charged daily. Those are the ones most likely to catch a business that has technically complied but has nobody clearly responsible for monitoring the exchange after go-live.

How the appointment penalty accumulates

The headline number sounds manageable until it is multiplied out. E-invoicing obligations attach to each Person individually, so exposure accumulates per entity rather than being capped at group level.

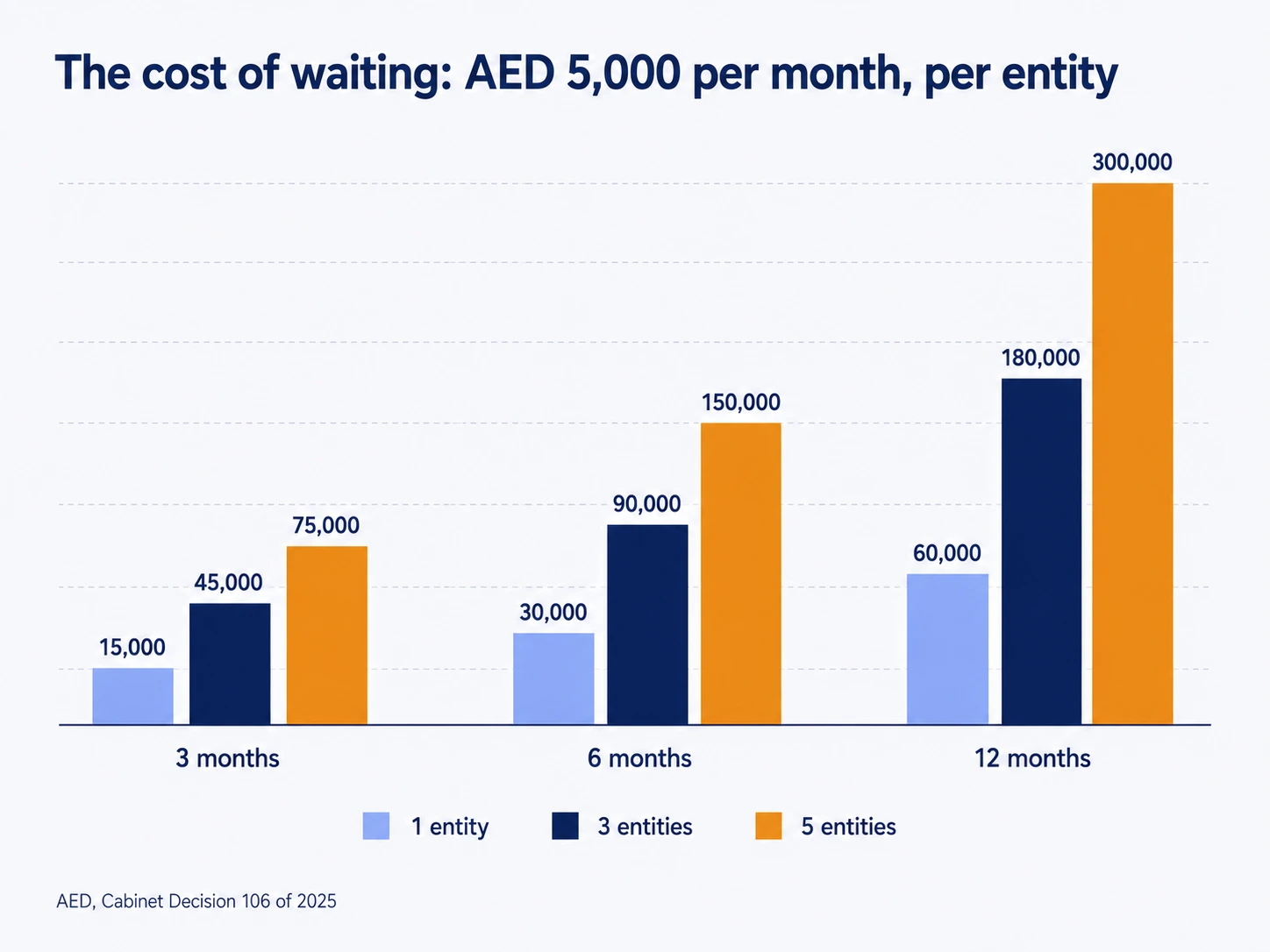

Failure to appoint — accumulated exposure

AED 5,000 per month, per non-compliant entity

GROUP SIZE

3 MONTHS

6 MONTHS

12 MONTHS

1 Entity

AED 15,000

AED 30,000

AED 60,000

3 Entities

AED 45,000

AED 90,000

AED 180,000

5 Entities

AED 75,000

AED 150,000

AED 300,000

Arithmetic on the CD 106/2025 monthly penalty. Other violations accrue separately.


The AED 2,500 per invoice figure does not belong here

The AED 2,500 per invoice penalty that circulates widely in UAE e-invoicing content comes from Cabinet Decision No. 40 of 2017, the general VAT penalty regime. It is not part of the e-invoicing rules.

Check the decision number on any penalty figure you are given.

Even so, for most CFOs the fine is not the largest number in this calculation. E-invoices that fail validation do not reach the customer, and an invoice that never arrives is an invoice that is never paid. For a mid-size wholesaler issuing several thousand invoices a month, even a modest rejection rate translates directly into stretched days sales outstanding and a working capital problem.

Invoices passing through a validation gate with one rejected, illustrating that UAE e-invoices failing PINT AE validation never reach the customer.

There is also a commercial exposure that no penalty schedule captures. As large buyers and government entities go live, they will expect suppliers to invoice them over the network. A contractor that cannot issue a compliant progress claim to a Phase 1 main contractor is not facing a fine — it is facing exclusion from the payment cycle.

Not sure which of these dates and numbers apply to you?

A free 30-minute gap analysis answers it →

What does "appointing an ASP" actually involve?

Appointing an ASP means formally engaging a Ministry of Finance Accredited Service Provider to transmit your e-invoices over the Peppol network. It involves selecting a provider, contracting, and then integrating your ERP with that provider — and the integration is usually the longer task.

The most common misunderstanding in the market is that a signed ASP contract equals compliance. It does not. Appointment satisfies the first deadline; compliance at go-live requires your ERP to produce complete, valid PINT AE invoices and exchange them through the ASP. Between contract and compliance sits field mapping, connector development, testing and a parallel run.


THE DISTINCTION THAT COSTS PROJECTS

Appointment is the formal engagement of an accredited provider by the deadline. Going live is when compliant invoices actually flow. Appointment without integration is not compliance.

Two Ministry of Finance lists — and only one of them counts

The Ministry of Finance publishes two separate lists, and conflating them is the most common error in circulating content.

The two Ministry of Finance lists

Published under Article 16 of Ministerial Decision No. 64 of 2025

LIST

WHAT IT MEANS

AS AT 22 AUG 2026

E-Invoicing Accredited Service Providers (ASPs)

Fully accredited. Each entry carries an accreditation number. These are the providers you can appoint.


39

Pre-Approved Service Providers Under Final Accreditation Assessment

Completed initial pre-approval, still undergoing final production assessment. Not yet accredited.


11

Source: Ministry of Finance register · Both lists move — recount before relying on any figure, including this one


THE FASTEST TEST

Accredited entries carry an accreditation number. Pre-approved entries do not.

Selecting the ASP itself deserves more rigour than it usually gets. Providers on the register differ meaningfully on pricing models — per-invoice versus subscription — pre-built ERP connectors, service level agreements, data residency and support arrangements. The right answer depends on your invoice volumes, your ERP landscape and your entity structure, not on whose advertisement you saw first.

That is a question ASPs themselves cannot answer objectively, because every ASP-authored guide concludes that the answer is them.

FOR TRANSPARENCY

Foxedg is not a Ministry of Finance Accredited Service Provider — and that is deliberate.

We are your independent integration and compliance partner. We advise on ASP selection, including providers we have worked with, currently Taxilla and Cygnet, both on the Ministry of Finance accredited list, which we disclose whenever we recommend them. We build and manage the ERP-to-ASP connection.

Our interest is that the integration works, whichever accredited provider sits on the other end, so you are not locked into one vendor's platform.

Plan the whole sequence backward from your go-live date. Across the implementations we have delivered, connector build and testing typically run 15 to 60 days depending on the ERP and the size of the business, inside a full compliance project of 6 to 10 weeks on a healthy ERP, or 10 to 16 weeks where data needs remediation. Where a ready-made connector exists, integration can complete considerably faster.

How should manufacturers, wholesalers and contractors prepare?

High-volume B2B sectors face the heaviest lift, but for different reasons. Manufacturers and wholesalers have a volume and data-quality problem. Contractors have a document-complexity problem.

SECTOR PROFILE A

Manufacturers & wholesalers

THE PROBLEM: VOLUME AND DATA QUALITY

Structured invoicing validates every field on every document, so master-data problems a human customer would overlook — missing TRNs, inconsistent item codes, incomplete customer records — become automatic rejections at scale.

Businesses running EDI with major customers also need clarity on how those flows coexist with Peppol exchange. The mandate does not switch off existing arrangements overnight.

SECTOR PROFILE B

Contractors & construction

THE PROBLEM: DOCUMENT COMPLEXITY

PINT AE defines a specific treatment for each of the sector's billing scenarios, and the mapping is precise rather than intuitive.

A contractor's gap analysis should inventory every billing scenario on live projects, not just the standard invoice. The table below is where most of the surprises sit.


Construction billing scenarios under PINT AE

The mappings that are least intuitive

SCENARIO

PINT AE TREATMENT

Milestone and instalment billing

Falls under the continuous-supply scenario

Retention

Must not appear on the e-invoice at all. The invoice shows the net amount payable after the retention adjustment; the retention calculation moves to a separate commercial document. A separate electronic tax invoice, with applicable VAT, is issued when the buyer becomes liable to release the retained amount.

Advance payments

A tax invoice is required at the time of receipt. The final invoice covers only the remaining balance and references the advance in the Preceding Invoice Reference field.

Sector-specific charges

e.g. Dubai Municipality surcharge

Reported under Document Level Charges

Two contrasting invoice stacks representing the volume challenge for wholesalers and the document-complexity challenge for contractors under UAE e-invoicing.

Both profiles share a structural feature: multiple entities, branches and joint arrangements, each of which needs its own assessment against the threshold and its own connection plan. This is where sequencing the rollout across the group pays for itself.

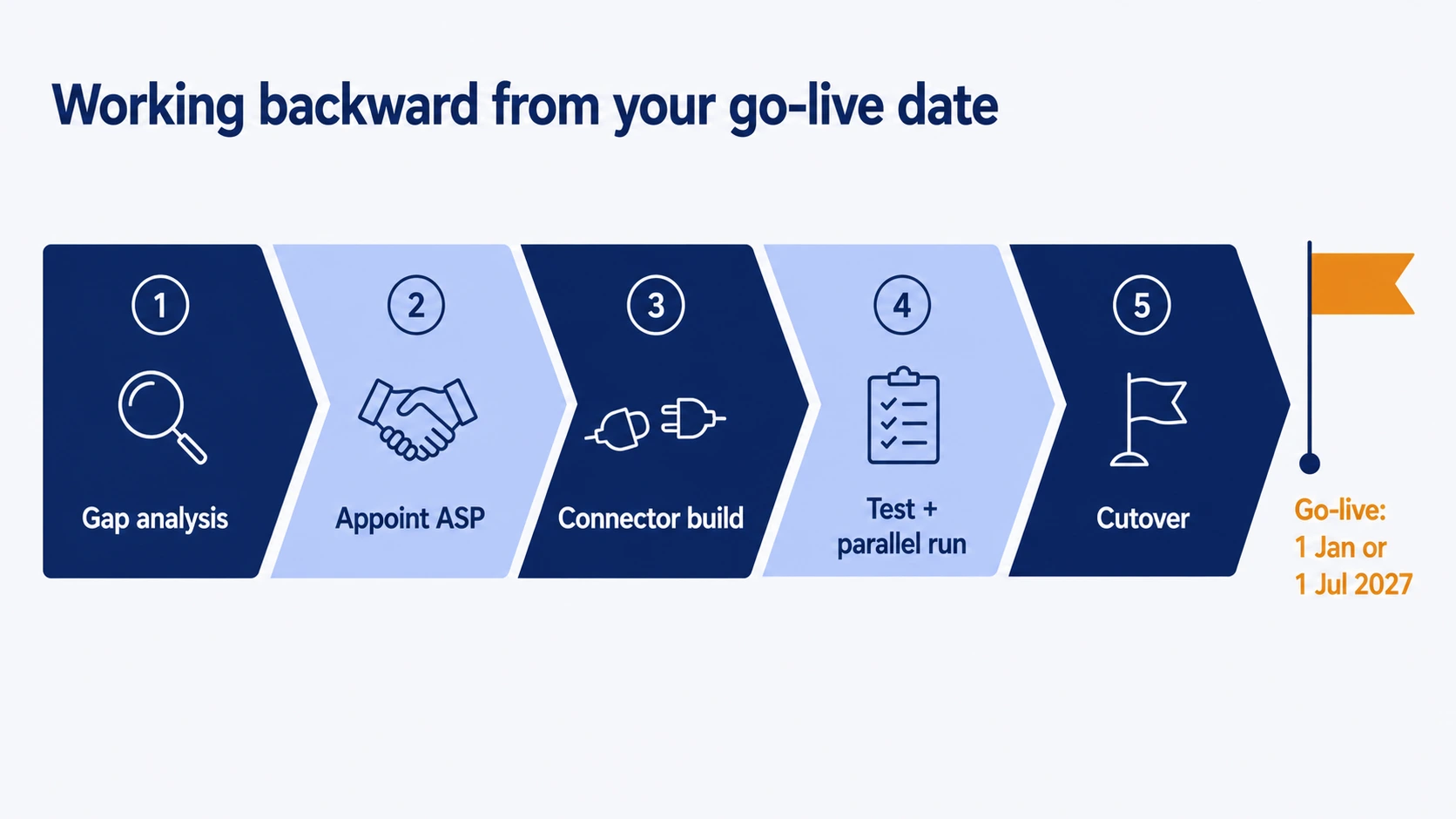

The backward plan from your go-live date

To meet a UAE e-invoicing deadline, work backward from go-live: run a gap analysis, shortlist and appoint an ASP, build and test the ERP integration, then run parallel invoicing before cutover.

START HERE

Gap analysis

Inventory your entities, systems, invoice types and data quality against PINT AE requirements. If you are still establishing whether your accounting system is the problem, start with the system-by-system guide.

DEADLINE-BOUND

ASP selection and appointment

Shortlist against criteria that fit your volumes and ERP landscape, then contract. This is the step with a hard date attached — 30 October 2026 for Phase 1, 31 March 2027 for Phase 2.

THE LONG POLE

Connector build

The work that makes your ERP speak PINT AE — field mapping, transformation, error handling. On a customised install this is where the time actually goes.

DO NOT COMPRESS

Testing and parallel run

Run alongside your existing invoicing. Every week of delay earlier in the plan is borrowed from this window, and this is the one phase you least want to shorten.

FIXED DATE

Cutover and go-live

1 January 2027 for Phase 1 — inside year-end close. 1 July 2027 for Phase 2. These dates have not moved and no further extensions have been announced.


If you are in Phase 2, you hold the better hand

The pilot exemption means an SME can connect and test now, penalty-free, while integration capacity is available. When Phase 2 demand converges on the same providers and integrators in early 2027, lead times and pricing will move — as they did in comparable regional rollouts, where businesses rushing mandatory sandbox testing to meet a deadline reported longer deployments, failed API calls and higher rework costs.

The advantage is not avoiding a fine; it is buying the same project at unhurried prices.

FAQ

Frequently asked questions

Not yet for most businesses. The voluntary pilot opened on 1 July 2026. The first mandatory obligation is the Phase 1 ASP appointment deadline of 30 October 2026; the first mandatory go-live is 1 January 2027 for businesses with revenue of AED 50 million or more.

Cabinet Decision No. 106 of 2025 sets five violations. Failure to appoint an accredited service provider carries AED 5,000 per month, per entity, recurring until compliance. Invoices and credit notes not issued on time carry AED 100 each, capped at AED 5,000 monthly, and two notification failures carry AED 1,000 per day. Pilot participants are exempt during the pilot.

Yes. The Ministry of Finance extended the Phase 1 ASP appointment deadline from 31 July 2026 to 30 October 2026. The go-live dates of 1 January 2027 for Phase 1 and 1 July 2027 for Phase 2 did not change, and no further extensions have been announced.

As at 17 August 2026 the Ministry of Finance listed 39 accredited service providers, with a further 11 pre-approved and undergoing final accreditation assessment. The lists are published under Article 16 of Ministerial Decision No. 64 of 2025. Both move as providers complete assessment, so check the register rather than any article's count.

Yes, as Phase 2. These businesses must appoint an accredited service provider by 31 March 2027 and issue e-invoices from 1 July 2027. They may also adopt early through the voluntary pilot, which opened on 1 July 2026, and remain exempt from administrative penalties while they test.

A Ministry of Finance Accredited Service Provider transmits e-invoices over the Peppol network and reports data to the Federal Tax Authority. Yes — every in-scope business must appoint one from the accredited register by its phase deadline. Being on the Pre-Approved list is not the same as being accredited.

Native support varies by system and version, and it is a separate question from whether your vendor is an accredited service provider — Tally and SAP are accredited, Zoho is pre-approved only, and QuickBooks has no entity on either list. Our system-by-system guide sets out where each stands and how to verify any vendor's claim yourself.

Appointment is the formal engagement of an accredited provider by the deadline. Going live is when compliant e-invoices actually flow from your ERP through that provider. The integration work between the two is the critical path, and appointment alone does not make you compliant.

Yes, fully. E-invoicing applies to any Person conducting business in the UAE, regardless of VAT registration status or mainland versus free zone establishment, and the same AED 50 million threshold determines the phase. Where the customer is a free zone entity but the ultimate beneficiary differs, the invoice must capture the beneficiary's details.

IN SUMMERY

The deadlines are fixed. Your timeline is not — yet.

Three things are worth carrying out of this guide.

  1. Your deadline is fixed by revenue: appoint by 30 October 2026 or 31 March 2027, go live 1 January or 1 July 2027.
  2. Penalties are the floor of the cost of inaction, not the ceiling. Rejected invoices and supplier exclusion cost more.
  3. Appointment without integration is not compliance. The ERP-to-ASP build is where deadlines are really met or missed.

Businesses that treat the current window as a rehearsal will barely notice their go-live date. Those that wait will buy the same project later, at rush prices, in less time.


NO OBLIGATION · YOU KEEP THE REPORT

Know exactly where you stand against your deadline


A free 30-minute gap analysis maps your entities, systems and invoice flows against your phase dates. No platform pitch, because we do not have a platform to pitch — and you keep the written report whichever ASP you eventually appoint.

Book a free gap analysis



Foxedg is a vendor-neutral e-invoicing integration partner. We are not an ASP. We help UAE businesses select an accredited service provider and build and manage the ERP-to-ASP connection.

Last verified: 22 August 2026
